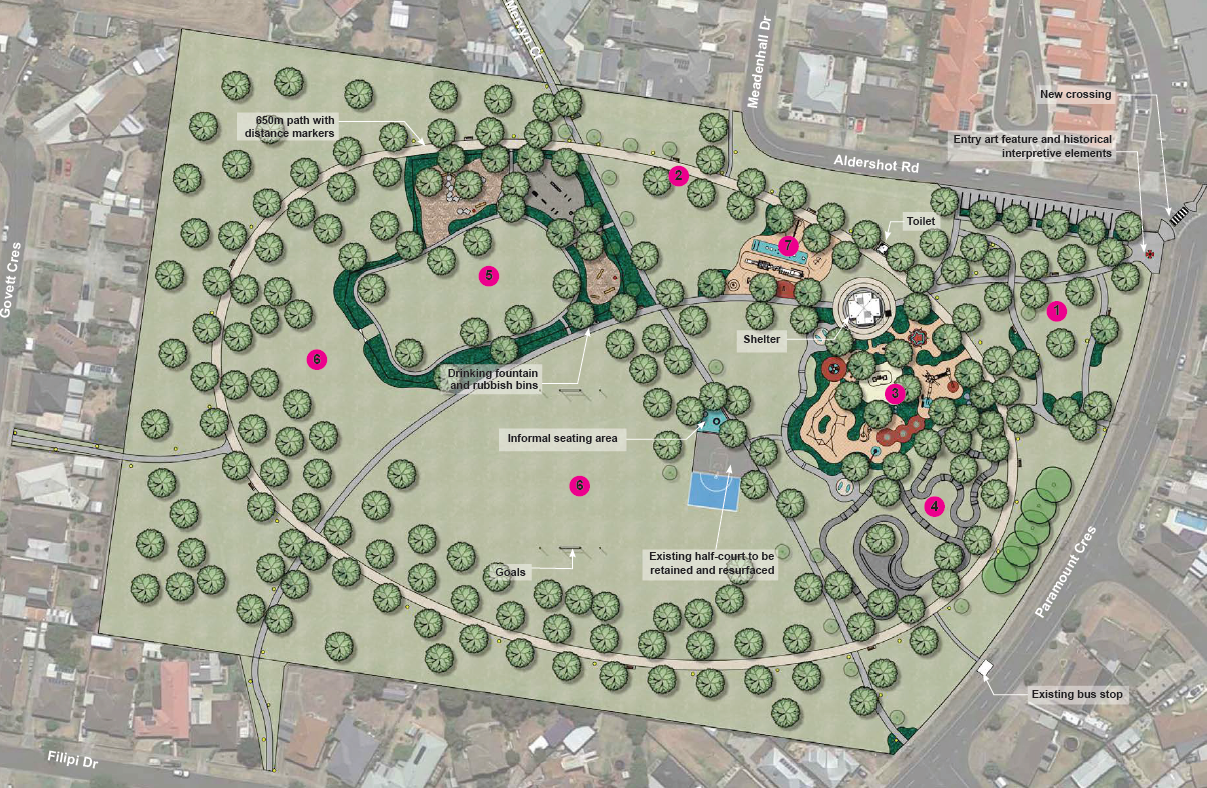

Aldershot Reserve is a large local park in St Albans Park. It currently has a shelter, BBQ, play equipment and basketball half court. We worked with the community to develop a new plan for this reserve that will better meet the needs of local residents. The masterplan was endorsed by Council in March 2021.

MASTERPLAN IMPLEMENTATION

  • Stage 1 - Fenced Dog Park

    Funding has been allocated to deliver the fenced dog park within Aldershot Reserve.
    We are undertaking detailed design of the dog park and anticipate construction will begin mid-2022.

  • Future Stages

    The City will continue to seek funding for delivery of future stages of the masterplan.


MASTERPLAN DEVELOPMENT PROCESS

We undertook two stages of community consultation during the design process.

  • In the first stage we gathered information from the community to assist with the preparation of a draft Concept Plan for Aldershot Reserve, St Albans Park. The initial feedback from the community was used to develop a concept design.
  • In the second stage of consultation the Concept Plan was shared with the community for feedback. 95% of respondents supported the plan.

The plan and supporting report was finalised and then endorsed by Council at the meeting held on 23 March 2021.


Project Timeline

  • Timeline item 1 - complete

    October 2019

    Preliminary site assessments completed

  • Timeline item 2 - complete

    November 2019

    Assessment of reserve by Crime Prevention Through Environmental Design (CPTED) specialist

  • Timeline item 3 - complete

    December 2019

    Stage 1 community consultation

  • Timeline item 4 - complete

    January - March 2020

    Draft concept plan development

  • Timeline item 5 - complete

    May - 9 June 2020

    Stage 2 community consultation - feedback on concept plan closed on 9 June, 2020.

  • Timeline item 6 - complete

    June - July 2020

    Community feedback collated.

    Data analysis completed. Summary engagement report complete. Full engagement report to be submitted to Council Meeting in 2021 with master plan.

  • Timeline item 7 - complete

    August - October 2020

    Minor updates to concept plan based on consultation feedback.

  • Timeline item 8 - complete

    March 2021

    Master plan endorsed by Council at meeting held on 23 March 2021.

  • Timeline item 9 - active

    Stage 1 - Fenced Dog Park

    Delivery of stage 1 will include the detailed design and construction of the fenced dog park. Design is currently underway and construction is expected to commence mid-2022.

  • Timeline item 10 - incomplete

    Future Stages

    Council officers will continue to seek funding opportunities for the delivery of the remaining master plan works.
